North Aurora Road Improvement Project

This project is expanding the roadway between Pennsbury Lane and Frontenac Road to accommodate two lanes of traffic in each direction as well as a center turn lane, multi-use trail and sidewalk, with lighting and drainage improvements and a sound wall. To accommodate the expanded roadway, the Canadian National/Wisconsin Central Railroad bridge over North Aurora Road will be improved/expanded as well.

The first phase to widen the road and add pedestrian and bicycle access was completed in 2023. The second phase to replace the roughly 110-year-old railroad bridge with a new structure that will span the newly expanded five roadway began in fall of 2025 and is anticipated to finish by late 2027, pending any unforeseen circumstances.

Current Updates

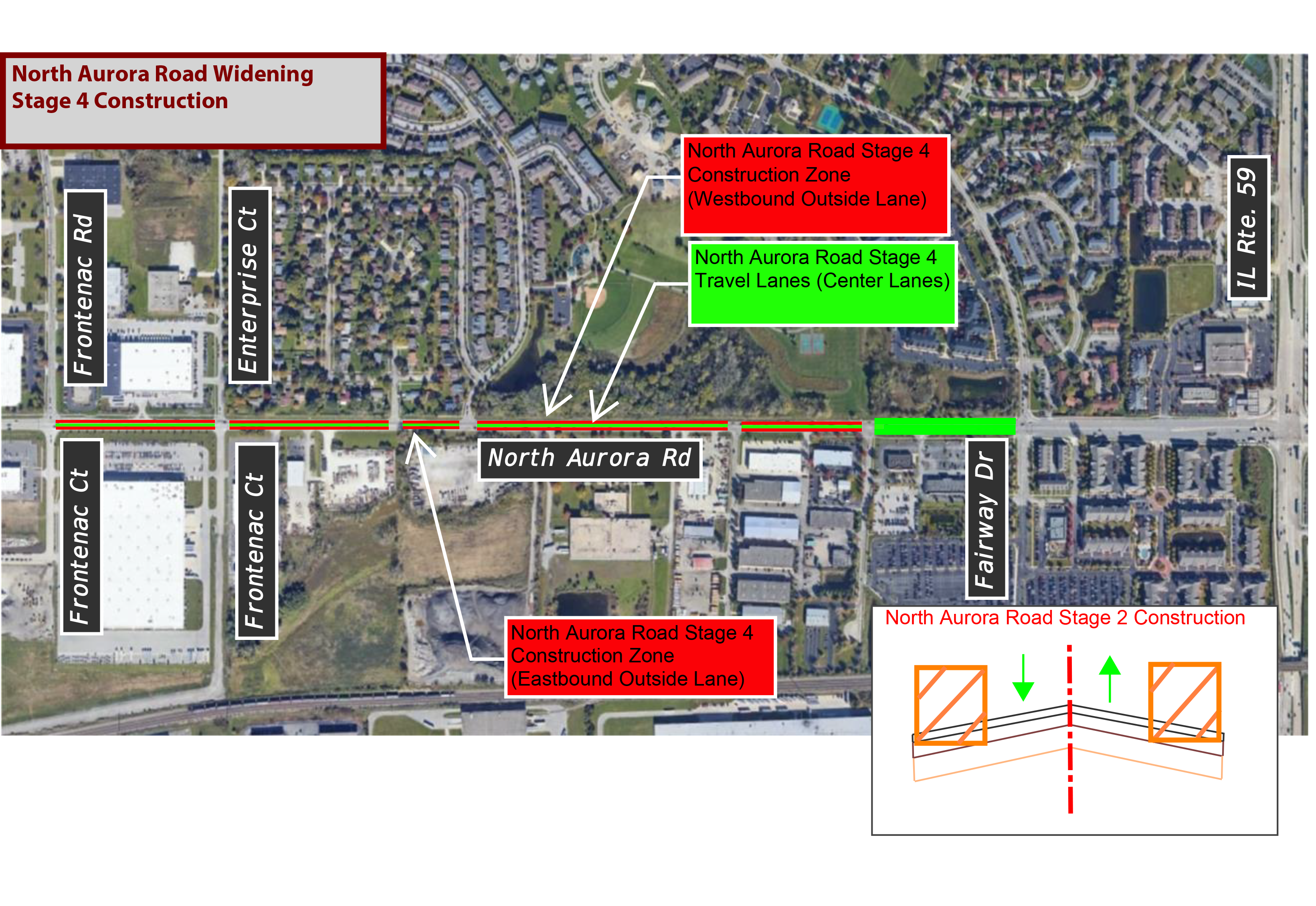

Updated Aug. 3, 2026: The North Aurora Road closure between Pennsbury Lane and Frontenac Road, and the detour to Diehl Road, has been lifted, and the road is now open to all traffic.

During the closure, crews completed a major milestone by relocating a petroleum pipeline that will allow the roadway to be widened as part of the long-term improvement project.

Work will continue through the fall with drainage infrastructure, storm sewer installation and utility relocations. Nicor will install a new gas main along the project corridor, while ComEd continues relocating transmission and distribution lines that cross the roadway. Drivers should expect occasional daytime lane closures through the fall.

Unexpected utility conflicts and additional coordination with the railroad have delayed some of ComEd's work, which is now expected to continue into next spring. After ComEd completes its work, additional utility relocations will take place before roadway construction can continue.

Additional closures at this location will be necessary next year to complete the remaining utility work, roadway reprofiling and construction of a temporary railroad bridge. Details about future closures, detours and traffic impacts will be shared as they become available.

North Aurora Road Project Team

The North Aurora Road Project Team was created in 2024 and granted authority by the Naperville City Council, Aurora City Council, and Naperville Township Board to review and approve agreements for the North Aurora Road widening project.

View the May 2 Meeting Agenda PAcket

Project Timeline

Improvement Phase 1: The first phase was conducted in partnership with the Naperville Township Road District which improved and widened the pavement between Fairway Drive and Frontenac Road. The scope of Phase 1 consisted of widening the existing three-lane road to accommodate two traffic lanes in each direction, with a center turn lane, multi-use trail and sidewalk, as well as a sound wall and improvements to roadway lighting and drainage. The first phase of work was completed in late summer 2023.

Improvement Phase 2: The second phase of work will improve the Canadian National/Wisconsin Central Railroad bridge over North Aurora Road in collaboration with the Naperville Township Road District and the City of Aurora (as each agency has jurisdiction over a portion of the roadway along this corridor). The scope of the project consists of replacing the roughly 110-year-old railroad bridge with a new structure that will span the newly expanded five traffic lanes on North Aurora Road, as well as the multi-use trail and sidewalk. In addition, roadway lighting, a pump station and increased vertical clearance will be provided. Construction on this phase began in fall of 2025 and is anticipated to finish by late 2027, pending any unforeseen circumstances.

Project Background

The City of Naperville began work in 2006 to secure funding to improve sections of North Aurora Road to reduce vehicle congestion and crashes and improve access for bicyclists and pedestrians in the area. North Aurora Road between Route 59 and Pennsbury Lane is a traffic bottleneck because it is the only remaining section of this corridor with a single lane for traffic in each direction for several miles on either side. Existing traffic already exceeds roadway capacity, and traffic is expected to grow to nearly 33,000 vehicles a day by 2040. The City is conducting this roadway improvement project in two phases, one to widen the road and add pedestrian and bicycle access, and another to replace a roughly 110-year-old railroad bridge in the project area.
